Post-Merger Integration Process: The Step-by-Step Process Behind Every Successful Acquisition

Summarise this Article with
post merger integration process

TL;DR

Need Help? Contact Us Now !

The post merger integration process is where most deal value is either created or destroyed. Studies consistently show failure rates between 50% and 70% for mergers that fail to deliver announced synergies, with integration shortcomings as the primary culprit. From the post-financial crisis consolidation waves in tech and pharma to the 2021 SPAC boom and recent AI-driven acquisitions, the pattern remains clear: deals fail not in the boardroom, but in execution.

So what is the post merger integration process? In plain terms, it’s the comprehensive effort to combine two companies’ operations, people, technology and corporate cultures into a single, unified business. Effective integration planning must begin during due diligence, not only after legal close. The diligence process surfaces critical integration risks that shape every subsequent decision.

Dextra Labs works as a technology due diligence and post merger integration partner supporting acquirers in the USA, UK, Singapore, UAE, Australia, Africa and India, helping to de-risk tech and data integration from Day One. This article walks through the key phases, work streams, common pitfalls and a practical technology-focused integration checklist for teams navigating the complexities of acquisition integration.

What Is Post-Merger Integration? (And Why It Decides Deal Success)

Post merger integration is the end-to-end process of combining two or more companies into a single, functioning business across strategy, operating model, technology, people, culture and brand. It encompasses every activity required to transform a legal transaction into a new entity that delivers on strategic objectives.

PMI activities span from signing and HSR/antitrust clearance through 12-36 months after close, when synergies and the target operating model are fully embedded. This timeline varies significantly based on deal complexity, regulatory requirements and geographic footprint.

The critical distinction: legal closing transfers ownership, but post merger integration makes the economics, systems and teams actually work together. Leading acquirers recognize this and deploy a documented integration playbook alongside an integration management office to coordinate hundreds of tasks across functions. Without this discipline, the acquired company becomes an administrative burden rather than a value driver.

Technology and data integration are now central to successful pmi in software, fintech, healthcare, energy, manufacturing and consumer sectors. In many deals, technology workstreams drive 40-60% of synergies, making technical diligence and integration planning essential to maximize deal value.

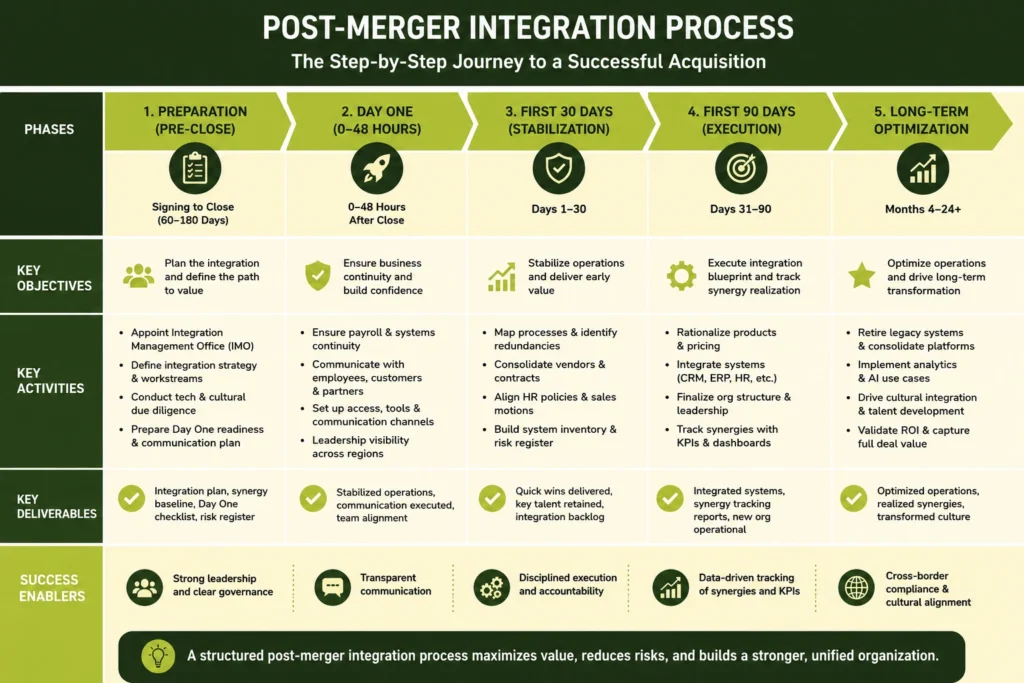

Phases of the Post-Merger Integration Journey

The integration process follows a practical 5-phase lifecycle: Preparation, Day One, First 30 Days, First 90 Days and Long-term Optimization. This structure aligns with leading consulting frameworks while reflecting real-world execution demands.

Each phase has distinct objectives, governance requirements and deliverables. The timeline must account for cross-border nuances such as data residency requirements under EU/UK GDPR, India’s DPDP Act and UAE data rules, plus time zone challenges for global integration teams.

post merger integration planning
Image showing experts involve in post merger integration planning at Dextra Labs

Phase 1: Preparation (Pre-Close)

The preparation phase typically runs from signing to legal completion, spanning 60-180 days depending on antitrust clearance and regulatory approvals. During this period, “gun-jumping” rules constrain what integration teams can actually execute, but planning proceeds at full speed.

An integration management office and Chief Integration Officer are appointed with clear charters and RACI matrices for workstreams including Technology, Product, People, Finance, Operations and Customer. Key pre-close outputs include:

  • Day One readiness checklist
  • Synergy baseline and targets (typically 10-20% cost savings via procurement)
  • Integration thesis linking strategic rationale to specific initiatives
  • High-level technology architecture map
  • Cultural risk assessment using frameworks like Hofstede’s dimensions for cross-border deals

Technology due diligence plays a critical role here. Dextra Labs evaluates architecture, cybersecurity posture, scalability, technical debt and integration feasibility across clouds and data centers in regions like the USA, Singapore, UAE and India. This assessment typically reveals 15-25% of code requiring refactoring and identifies post-merger integration challenges before they derail post-close timelines.

Preparation must also include a confidential communications plan covering internal announcements, customer retention scripts and regulator filings, ready to execute at close.

Phase 2: Day One (0-48 Hours After Close)

Day One is about stability and reassurance rather than deep integration. The goal is ensuring business continuity while providing clear direction to employees, key customers and partners.

Concrete Day One priorities include:

  • Ensuring payroll runs without interruption
  • Maintaining customer service continuity with shared SLAs
  • Switching email domains and access rights where legally permitted
  • Launching joint branding elements where planned
  • Activating emergency communication channels

Leadership visibility activities are essential: CEO video messages, town halls across time zones (US morning, UK midday, India/Asia evening), FAQ portals and dedicated integration mailboxes. Transparent communication sets the tone for the entire post merger integration phase.

Operational requirements include VPN access for merged teams, shared collaboration tools like Teams, Slack or Google Workspace and initial single sign-on decisions. The integration war room becomes active with clear escalation paths and decision rights, ensuring issues surface quickly to senior management.

Phase 3: First 30 Days – Stabilization and Quick Wins

The first 30 days focus on stabilizing operations, preventing customer and talent attrition and delivering visible quick wins that validate the deal thesis. This period separates disciplined acquirers from those who struggle with post merger success.

Specific tasks include:

  • Mapping overlapping processes and identifying redundancies
  • Consolidating vendor contracts where straightforward
  • Harmonizing key HR policies (leave, remote work, travel)
  • Aligning first combined sales motions

Technology teams complete a detailed system inventory covering ERPs, CRMs, data warehouses, cloud providers and cybersecurity tools. The target company’s systems must be fully documented before agreeing on future-state architecture at a high level.

Dextra Labs supports this 30-day period by turning due diligence insights into a prioritized integration backlog, risk register and high-level sequencing for migrations across US, UK, APAC and MEA entities. The diligence team’s knowledge transfers directly to integration teams, preserving valuable insights.

Target metrics include retention of greater than 85-90% of identified key talent and maintaining service-level agreements for critical customers. Employee retention in this window often determines long-term value realization.

Phase 4: First 90 Days – Executing the Integration Blueprint

By day 90, the combined company should be executing the detailed post merger integration plan with clear milestones, budgets and accountability for each workstream. This is when the integration strategy translates into measurable progress.

Typical initiatives include:

  • Rationalizing overlapping product lines
  • Aligning pricing models across markets
  • Merging or integrating CRM and ticketing systems
  • Starting human resources system consolidation

Structural moves accelerate: finalizing leadership appointments, publishing new organizational structures, establishing reporting lines and launching decision forums. A steering committee meets regularly to review progress and resolve cross-functional conflicts.

Formal synergy tracking becomes essential. Define cost and revenue synergy KPIs, create dashboards and review monthly in the steering committee. Without this discipline, synergy realization becomes aspirational rather than managed.

Dextra Labs helps integration teams de-risk ERP, CRM, data lake and core platform migrations by modeling dependencies and proposing phased cutovers tailored to regions like India, Singapore, UAE and Africa. This technical roadmapping prevents the common trap of over-optimistic timelines that ignore migration complexity.

Phase 5: Long-Term Optimization (Months 4-24+)

Long-term optimization moves the merged entity beyond integration to transformation and continuous improvement. The future company emerges as something greater than the sum of its parts.

Typical long-term work includes:

  • Retiring 50% or more of legacy systems
  • Consolidating data platforms
  • Implementing unified analytics and AI use cases
  • Refining the target operating model

Cultural integration activities extend over 12-24 months: leadership development programs, shared values refresh, cross-company rotations and pulse surveys. Corporate cultures don’t merge overnight and addressing concerns about identity and belonging requires sustained effort.

Final synergy realization and ROI validation often occur around the 18-36 month mark, depending on industry complexity and regulatory constraints. Deal value captured during this phase typically exceeds early quick wins.

Dextra Labs can periodically reassess the technology stack post-integration to identify further cost optimization and innovation opportunities, especially in cloud, data and cybersecurity across global operations.

Key Elements of an Effective Post-Merger Integration Strategy

A robust integration strategy rests on four pillars: Direction, Value/Momentum, Structure/Organization and Technology. These elements translate into practical decisions about what to integrate, at what speed, in which sequence and where to preserve autonomy.

Trade-offs are inevitable. Fast system consolidation risks 10-15% operational disruption, while phased approaches may delay synergies. Centralization enables efficiency but can undermine local market agility. A formal integration thesis connects strategic rationale to specific initiatives and KPIs, guiding these decisions.

Setting Direction and Integration Scope

Leadership must articulate a clear vision of what the combined company will look like in 2-3 years, including markets, products and operating model. Without this north star, integration efforts become fragmented and reactive.

Defining integration scope requires deciding between full absorption, selective integration, or preservation of certain units. Global banks, for example, often integrate risk and compliance fully while preserving local brand and front-office differences in markets like the UK, India or UAE.

Key stakeholders including boards, investors and senior leaders must align on non-negotiables: regulatory capital ratios, cybersecurity standards, customer data protection. Ambiguity here creates paralysis downstream.

Dextra Labs helps translate strategic direction into concrete technology integration scope, identifying which platforms to standardize versus retain based on architecture assessments across the USA, UK, Singapore, UAE, Australia, Africa and India.

Maintaining Momentum and Value Focus

Successful post merger integration best practices require speed with discipline: moving fast enough to capture synergies but not so fast that operations break. Integration teams must maintain momentum while managing risk.

Prioritize “no-regret” moves like procurement consolidation and shared infrastructure while sequencing complex migrations more cautiously. Practical techniques include:

  • 90-day integration sprints with clear deliverables
  • Regular value reviews with executive sponsors
  • Visible synergy scorecards shared across the organization

Early value capture in technology, data center consolidation, cloud optimization, license rationalization, provides major leverage. Partners like Dextra Labs bring independent tech due diligence that identifies these opportunities before deal closing.

In one cross-border deal, early technology synergies from cloud consolidation generated savings that funded subsequent AI pilot programs, turning integration from a cost center into an investment platform.

Designing the Future Organization

The organizational and people dimension of PMI encompasses corporate structure, roles, incentives and governance. Decisions about central versus regional hubs, shared services and where critical capabilities sit determine how effectively the new company operates.

Poorly defined structures and ambiguous leadership roles slow integration and create talent flight. In one merged entity, failure to clarify decision rights between US headquarters and India delivery centers caused 3-6 month delays and widespread frustration. Retaining key talent requires clarity about career paths and authority.

Technology operating model decisions, DevOps practices, platform ownership, incident management, should be harmonized as part of organizational design. Dextra Labs assesses technology organization maturity and proposes transition states that align technical and business structures.

Technology, Data and Cybersecurity as Core Enablers

Technology integration is a central pillar of modern PMI, not a backend detail. Major decisions include which CRM/ERP to keep, how to integrate data platforms, how to enforce consistent identity and access management and how to align cybersecurity controls across geographies.

Common integration patterns include:

PatternRisk LevelSpeedBest For
CoexistenceLowSlow synergiesRegulatory constraints
Phased migrationMediumBalancedMost enterprise deals
Big bang cutoverHighFastSimple tech stacks
API-based federationVariableScalableModern architectures

Dextra Labs, as a technology due diligence consultant, benchmarks current stacks, estimates integration complexity and recommends realistic timelines for clients in the USA, UK, Singapore, UAE, Australia, Africa and India. Regulatory considerations, SEC, FCA, MAS in Singapore, RBI and SEBI in India and emerging African regulators, heavily influence architectural choices and data residency decisions.

post-merger integration plan
post-merger integration plan & process

Common Challenges and Risks in the Post-Merger Integration Process

Even well-planned deals encounter predictable PMI risks, many of which can be identified during due diligence. A KPMG survey found that 55% of integration failures stem from planning gaps, 45% from culture and 40% from technology complexity.

Historical examples illustrate the stakes. AOL-Time Warner’s 2000 merger resulted in a $98B write-down due to culture and IT clashes. HP-Autonomy saw an $8.8B impairment from accounting and technology misrepresentation. Contrast these with Disney-Pixar, where value doubled through careful culture preservation, or Exxon-Mobil’s disciplined PMI that delivered over $100B in synergies.

Insufficient post merger integration planning and Unrealistic Timelines

Many organizations treat PMI as an afterthought, starting detailed integration planning only after regulatory approvals. This compresses timelines and increases errors. Late-discovered blockers, incompatible core systems, missing data mapping, unexpected regulatory approvals in markets like UAE or Africa, derail execution.

Approximately 40% of deals discover incompatible ERPs during integration, a problem that structured technology roadmaps and scenario analysis could expose early. Partners like Dextra Labs help adjust expectations by revealing complexity during the diligence process.

Integration timelines must distinguish between Day One readiness, first 100 days changes and multi-year platform replacements. Conflating these leads to either premature announcements or missed milestones.

Leadership Gaps and Unclear Decision Rights

Who is in charge of integration and how quickly decisions can be made determines execution velocity. Dual leadership structures, unresolved roles for founders and regional CEOs competing for authority create paralysis.

In one cross-border transaction, lack of a strong Chief Integration Officer and steering committee led to conflicting integration instructions across continents. Teams in India received different directives than those in the US, causing duplicate efforts and frustration.

Best-practice governance includes an integration sponsor (CEO or business unit head), Chief Integration Officer, integration management office and functional workstream leads. Experienced advisors can help define and coach this governance structure, especially for first-time acquirers.

Cultural Integration and Employee Engagement

Merging distinct corporate cultures, workstyles and expectations presents significant challenges, particularly in cross-border deals. Concrete culture clashes include attitudes toward hierarchy, decision-making speed, risk tolerance, remote work policies and work-life balance. Cultural differences between US and India operations, for example, can drive 21% attrition without proactive intervention.

Ignoring company culture leads to “us vs. them” dynamics and slower collaboration. Practical tools include cultural assessment diagnostics, integration workshops, leadership role-modeling, recognition programs and regular sentiment surveys.

Technology choices, collaboration platforms, monitoring policies, communication tools, either support or hinder cultural alignment and should be considered explicitly as part of the change management program.

Technology and Data Integration Risks

Technology integration is one of the most underestimated sources of PMI risk and cost overruns. Common challenges include:

  • Undocumented legacy systems
  • Overlapping vendors and duplicative licenses
  • Incompatible data models
  • Tech talent attrition post-announcement
  • Hidden cybersecurity vulnerabilities in the acquired company

Failed ERP consolidations, poorly planned data migrations corrupting customer records and breaches discovered after deal closing are all too common. Cloud vs. on-premise mismatches and SaaS overlap across the USA, Europe, Asia and Africa compound complexity.

Structured technology due diligence by Dextra Labs before signing and during early integration planning uncovers these risks and proposes feasible patterns for remediation. This assessment addresses supply chain management systems, core platforms and integrated solutions that underpin operations.

Slow or Fragmented Execution

Even with good plans, execution stalls due to overwhelmed line managers, competing priorities, or poor communication between acquiring and target teams. Fragmented execution manifests as duplicate efforts, conflicting communications to key customers and local teams ignoring central integration directives.

Solutions include maintaining a single integrated backlog, deploying transparent tracking tools and conducting regular progress reviews. Weekly integration management office stand-ups and monthly sponsor reviews keep the organization on the same page.

Agile-inspired practices, short sprints, retrospectives, prioritized workstreams, maintain momentum while adjusting to new information. In one global integration, sequencing by region (starting with UK and India pilots, then rolling out to US, Singapore, UAE and African entities) reduced risk and improved coordination significantly.

Roles and Responsibilities in the Integration Process

Successful PMI depends on clearly defined roles from the board to frontline teams, with no ambiguity about who decides what. Poor communication about responsibilities is among the most common challenges in post-acquisition integration activities.

Key actors include top executives, the integration management office, functional leaders, human resources, technology leaders and external advisors. While roles differ between public companies, PE-backed portfolios and founder-led firms, core responsibilities remain similar.

Continuity matters: using due diligence team members in integration roles preserves context and learning from the diligence process.

Board, CEO and Executive Sponsors

The board and CEO define overall strategic objectives, risk appetite and success metrics for the merger. The CEO serves as primary sponsor of PMI, visibly reinforcing priorities, resolving conflicts between business units and supporting tough trade-offs.

An executive sponsor model assigns each major workstream, Customer, Operations, Technology, a C-level owner accountable to the board. Global CEOs managing operations in regions like the USA, UK, India, UAE and Africa must navigate regulatory and cultural differences in oversight.

Executives must ensure integration goals reflect in performance targets and incentive plans for the first 12-24 months post-close. Alignment between corporate strategy and individual incentives drives accountability.

Integration Management Office (IMO) and Chief Integration Officer

The integration management office serves as the central coordination body, with responsibilities for planning, tracking, issue escalation and reporting. The Chief Integration Officer provides single point of accountability for day-to-day integration decisions.

The IMO manages practical artifacts including:

  • Master integration plan
  • Risk register
  • Synergy dashboard
  • Communication calendar
  • Decision log

Technology integration often represents the largest and most complex workstream, requiring a dedicated technology integration lead. This integration manager liaisons with partners like Dextra Labs for complex system migrations.

Essential IMO skills include program management, stakeholder management, data literacy and familiarity with cross-border regulatory environments.

Functional Leaders and Operating Teams

Functional leaders in Finance, HR, Sales, Operations, Technology, Legal and Compliance translate integration strategy into concrete actions. The CFO leads chart-of-accounts harmonization; the CHRO manages role mapping and retention packages; the CIO/CTO oversees platform integration.

Pairing leaders from both legacy organizations to co-lead workstreams builds trust and surfaces local knowledge. Functional teams must balance keeping business-as-usual running while executing integration tasks, requiring careful sequencing and capacity planning.

Technology leaders often rely on external specialists such as Dextra Labs to augment internal bandwidth and provide independent challenge on integration assumptions.

Human Resources, Change and Communications

HR plays a central role in workforce planning, legal compliance for redundancies, retention of critical talent and culture initiatives. Employee training on new systems, policies and expectations enables smooth transitions.

HR partners with communications teams to create consistent messaging and handle sensitive topics like role changes and relocations. Early clarity on career paths and incentives reduces attrition among engineers and sales teams in high-growth markets. Prioritize communication that addresses concerns directly rather than corporate-speak that creates uncertainty.

Structured change management frameworks focus on awareness, desire, skills and reinforcement. HR and change teams coordinate with technology leaders when new collaboration tools or hybrid-work norms are introduced post-merger.

External Advisors and Technology Due Diligence Partners

Complex integrations often require external support bringing experience, capacity and independent perspective, especially on technology, cyber risk and data. Dextra Labs works as a specialist technology due diligence and integration partner, assessing architecture, security, scalability and integration risk for transactions across the USA, UK, Singapore, UAE, Australia, Africa and India.

External experts design realistic roadmaps, challenge synergy assumptions and provide specialized skills in cloud, data and DevOps not available internally. Advisors work closely with the IMO to ensure knowledge transfer to internal teams.

For regulatory or national-security sensitive sectors, local advisors in each jurisdiction complement global expertise from firms like Dextra Labs.

Technology Due Diligence in Support of Post-Merger Integration

Traditional financial and legal due diligence are no longer sufficient for deal making. Technology due diligence now serves as a primary driver of PMI success by informing integration strategy beyond deal valuation.

Tech DD highlights architectural fit, technical debt and cyber risk that shape every integration decision. Dextra Labs specializes in this area, working with corporate buyers and private equity sponsors planning integrations across the USA, UK, Singapore, UAE, Australia, Africa and India.

Assessing Architecture and Integration Complexity

Technology due diligence maps current systems: applications, infrastructure, integrations and dependencies with external vendors. Typical questions include:

  • Single or multi-cloud environment?
  • Mainframe or modern stack?
  • Monolith vs. microservices architecture?
  • Availability and maturity of APIs?
  • Existing integration patterns?

Findings drive decisions: adopt buyer’s platform, retain target’s system, or build a new shared platform. Dextra Labs produces visual architecture blueprints and integration complexity scores helping executives in global hubs prioritize investments.

Architecture assessment also considers resilience, performance and scalability to support the combined customer base post-merger.

Data, Analytics and Reporting Integration

Understanding data models, quality, lineage and ownership in both organizations shapes integration steps. Challenges include duplicate customer IDs, inconsistent product hierarchies and conflicting KPI definitions across regions.

Harmonizing data enables unified dashboards for cross-selling and regulatory reporting after a merger. Dextra Labs designs interim data integration layers, data lakes or warehouse consolidation plans supporting both operational reporting and advanced analytics.

Data privacy and residency considerations, EU/UK GDPR, India’s data protection laws, PDPA in Singapore and emerging African regimes, influence where and how data can be stored and processed.

Cybersecurity, Compliance and Risk Posture

Cyber risks surface post-deal: unpatched systems in the acquired company, shadow IT, weak identity management. Due diligence should include vulnerability assessments, security architecture reviews, incident history analysis and third-party risk reviews.

Integrating two security programs requires standardizing policies, tools (SIEM, EDR, IAM) and incident response procedures. Dextra Labs benchmarks security maturity and proposes prioritized hardening plans aligned with standards relevant in the USA, UK, UAE, Singapore, Australia, Africa and India.

Regulators and customers increasingly expect clear evidence that cyber and privacy risks were assessed and mitigated as part of M&A activity.

Regulatory and Industry-Specific Technology Constraints

Different sectors, financial services, healthcare, critical infrastructure, defense, telecom, face strict rules on systems, data and outsourcing that shape PMI options.

Technology due diligence maps relevant regulations: payments and banking rules in India, FCA/PRA expectations in the UK, MAS regulations in Singapore, or sector-specific guidelines in Gulf and African markets. In one fintech acquisition, planned system consolidation required regulatory approvals that extended integration timelines by several months.

Dextra Labs aligns integration roadmaps with regulatory milestones to avoid delays and non-compliance. Cross-border cloud deployment strategies must reconcile local residency requirements with global efficiency goals.

Post-Merger Integration Checklists and 100-Day Plans

Checklists and 100-day plans ensure critical steps aren’t missed during hectic integration periods. A practical post merger integration checklist covers governance, people, processes, technology and customers.

While 100-day plans are common, they must be tailored by deal type, size and regulatory environment rather than applied mechanically. Technology integration milestones and risk mitigations should be fully embedded in these plans, not treated as a separate track.

post merger integration methodology
post merger integration methodology and checklists

Team and Leadership Integration Checklist

Essential early actions related to people and leadership include:

  • Confirm key appointments within first two weeks
  • Finalize organizational charts and communicate reporting lines
  • Identify critical talent in engineering, sales and operations
  • Assign retention measures including stay bonuses where appropriate
  • Establish clear escalation paths from local teams to global integration leaders
  • Standardize onboarding plans for acquired employees

The same process should apply whether integrating companies in India, Africa, Australia or the UAE.

Communication and Stakeholder Management Checklist

Communication elements must address narrative, key messages, channels, cadence and feedback loops. Stakeholder groups include employees, middle management, key customers, suppliers, regulators and investors across geographies.

Tools include centralized FAQ pages, regular email updates, internal social platforms and leadership Q&A sessions. Timing and content should be tailored for different markets considering public disclosure rules in the USA vs. UK and cultural norms in the UAE or India.

Integration communications synchronize with technology milestones impacting user experience, system changes, new tools, downtime windows.

Day One and First 100 Days Operational Checklist

Day One checks include:

  • Legal entity updates
  • Bank signatories
  • Payroll continuity
  • Critical supplier contracts
  • Emergency contacts

100-day items include harmonizing key policies, aligning credit and risk limits, mapping overlapping product lines and defining cross-sell opportunities. Operational KPIs (customer satisfaction, on-time delivery, incident volume) ensure no hidden degradation occurs.

Dextra Labs helps define realistic 100-day technology milestones like completing system inventories, agreeing future-state architecture and launching pilot integrations. The plan should be updated as new information emerges.

Technology Integration Checklist

The technology post merger integration checklist covers systems, infrastructure, data and security steps necessary for safe, orderly integration:

  • Complete application inventory
  • Classify critical systems
  • Review vendor contracts and consolidation opportunities
  • Map data flows and dependencies
  • Catalog interfaces and integration points
  • Risk-based prioritization of migration activities
  • User identity consolidation and access policies
  • Endpoint management for combined workforce
  • Backup and disaster recovery strategies

Dextra Labs provides pre-built technology checklists adapted for different sectors and jurisdictions, validated on deals in the USA, UK, Singapore, UAE, Australia, Africa and India. Technology checklists must integrate with business and regulatory requirements.

Post-Integration Review, Optimization and Continuous Improvement

Integration doesn’t end when systems merge. Organizations need structured reviews to confirm value realization and identify further improvements. Post merger activities extend well beyond the first 100 days.

Reviews at 6, 12 and 24 months link back to original deal hypotheses and synergy targets. Track both financial and non-financial metrics: time-to-market, innovation rates, customer churn, employee engagement and cyber incidents.

Optimization often includes rationalizing remaining legacy systems, refining operating models and renegotiating vendor contracts based on combined scale. Partners like Dextra Labs conduct post-integration technology health checks to benchmark the new stack and propose modernization initiatives.

Measuring Success and Learning from the Deal

Companies should define success metrics at the outset and consistently measure against them post-integration. Examples include achieving targeted cost synergies, expanding into new markets like Southeast Asia or Africa, or improving digital capabilities.

Post-mortems and lessons-learned workshops with integration teams, business units and technology leaders improve the next M&A cycle. Documentation of what worked and what didn’t feeds back into organizational playbooks.

Reviews should honestly assess the role of technology and data integration in success or underperformance. Insights from partners like Dextra Labs provide objective perspective on technical execution.

Embedding a Repeatable Integration Capability

Frequent acquirers benefit from building a reusable PMI capability: standard tools, roles, templates and checklists adapted for each deal. A central corporate development or M&A integration team can own and maintain this toolkit.

Playbooks should remain flexible, updated after each transaction and tuned for different deal types, bolt-on, carve-out, or large transformational merger.

Dextra Labs helps design and refine the technology and data components of these playbooks based on multi-deal experience across global markets. Post merger integration framework development transforms PMI from a reactive scramble into a strategic capability differentiating successful acquirers in competitive industries.

How Dextra Labs Supports Technology Due Diligence and Post-Merger Integration

Dextra Labs serves as a specialist partner for technical due diligence and integration planning, working with clients across the USA, UK, Singapore, UAE, Australia, Africa and India on complex, technology-heavy deals.

Core offerings include:

  • Pre-deal technology due diligence
  • Integration architecture design
  • Cybersecurity assessments
  • Integration roadmap creation
  • Post-integration optimization reviews

Dextra Labs works alongside internal teams and other advisors, feeding findings directly into the integration management office and functional workstreams. The approach ensures that technology insights translate into actionable integration decisions rather than isolated technical reports.

For organizations planning a merger or acquisition, engaging Dextra Labs early in the deal cycle de-risks technology integration and accelerates value realization. Whether you’re evaluating a target company in Singapore, executing post acquisition integration in India, or optimizing systems across African markets, early technology diligence shapes successful post merger integration from the start.

FAQs:

When should post-merger integration planning begin?

Integration planning should begin during due diligence, not after legal close. This is when the most consequential risks can be identified, when integration assumptions can be tested against reality, and when decisions about platform and people can be made with the best available information. Starting too late compresses execution timelines and makes avoidable problems expensive.

What should a post-merger integration plan include?

A post-merger integration plan is the master document governing the combined integration effort. It defines workstreams, milestones, owners, budgets, risk mitigations and synergy targets across every function, including Technology, People, Finance, Operations and Customer. An effective plan distinguishes between Day One readiness, first-100-day priorities and longer-term platform work, and is maintained as a living document throughout the lifecycle.

What are the most common post-merger integration challenges?

The most consistently damaging challenges are insufficient planning (especially for technology), unclear leadership and decision rights, cultural friction between merging organizations, undiscovered cybersecurity risks and unrealistic migration timelines. Most are predictable and addressable through structured diligence and disciplined governance.

Why do so many post-merger and acquisition integrations fail?

Mergers fail primarily in execution, not strategy. The deal logic may be sound, but integration breaks down due to planning gaps (identified in roughly 55% of failures), cultural misalignment (45%) and technology complexity (40%), according to KPMG research. The common thread across failures is treating integration as an afterthought, something to figure out after the deal closes.

How long does the post-merger integration process typically take?

For most mid-to-large transactions, the full integration process spans 12 to 36 months. Day One readiness is achieved in the first 48 to 72 hours. Stabilization and quick wins occupy the first 30 to 90 days. Platform rationalization, synergy realization and cultural embedding extend well into year two and sometimes year three, depending on deal complexity and regulatory requirements.

What role does technology due diligence play in post-merger integration?

Technology due diligence surfaces the architectural fit, technical debt, data risks and cybersecurity vulnerabilities that shape every integration decision. In technology-intensive deals, it’s also a direct input to synergy targets, since 40 to 60% of synergies often flow through technology workstreams. Without rigorous technical diligence, teams make integration decisions based on assumptions that may not survive contact with reality.

What is an Integration Management Office (IMO) and why does it matter?

The IMO is the central coordination body for post-merger integration. It manages the master integration plan, risk register, synergy dashboard, communication calendar and decision log. Without an IMO, integration workstreams operate in silos, issues don’t escalate properly and leadership loses visibility into what’s actually happening across the combined organization.

How do you manage post-merger integration risks in cross-border deals?

Cross-border deals introduce regulatory complexity across multiple jurisdictions, cultural differences that can drive significant attrition if unaddressed, and time zone challenges for global integration teams. Risk management requires jurisdiction-specific regulatory mapping, proactive cultural assessment, and governance structures that give regional teams enough authority to execute while keeping global integration aligned.

Author

Share this article :

From Strategy to Scaling – Claim Your AI Consulting Toolkit

Unlock expert insights, proven frameworks, and ready-to-use templates that help you adopt, implement, and scale AI in your business with confidence.


Need Help?
Scroll to Top
